Hundreds of tribal families in Madhya Pradesh’s Chhatarpur and Panna districts have been staging a dramatic ‘Chita Andolan’ (funeral pyre protest) for 9 days, opposing their forced displacement under the Ken-Betwa Link Project. The protest began under the Barana River bridge and drew nationwide attention as tribal women, some carrying infants, lay on symbolic funeral pyres to show their desperation.
The tribal protests in Madhya Pradesh come at a critical moment. The project, India’s first-ever river interlinking initiative, has construction actively underway. Yet thousands of affected families say they have received no fair compensation and no proper place to go.
What Exactly Is the Ken-Betwa Link Project?
The Ken-Betwa Link Project is a massive water infrastructure scheme that aims to transfer surplus water from the Ken River in Madhya Pradesh to the Betwa River in Uttar Pradesh. It is designed to address the chronic water scarcity of the Bundelkhand region. It is one of India’s most drought-prone and underdeveloped areas.

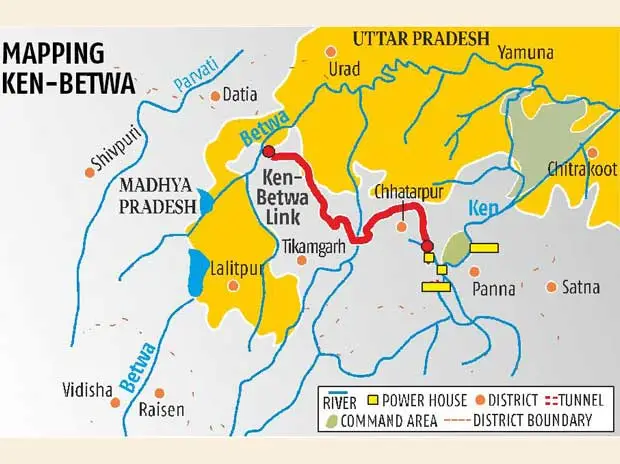

At the heart of the project is the Daudhan Dam. It is a 77-metre high and 2.13-kilometre long concrete structure being built on the Ken River inside the Panna Tiger Reserve. Once complete, a 221-kilometre canal will carry water from Ken to Betwa.

The project costs Rs 44,605 crore. The Central Government bears 90 percent of that cost and the two state governments share the remaining 10 percent. Prime Minister Narendra Modi laid the foundation stone in Khajuraho on December 25, 2024, on the 100th birth anniversary of former PM Atal Bihari Vajpayee, who had first championed the river interlinking vision.


Why Does India Need This Project?
The answer lies in Bundelkhand’s decades of misery. Stretching across 10 districts in Madhya Pradesh and Uttar Pradesh, the region has faced repeated drought, crop failure, farmer suicides, and mass outward migration for generations. Only 7 percent of Panna district’s agricultural land is irrigated. That number tells the entire story.
The Ken-Betwa Link Project promises to irrigate more than 8 lakh hectares of farmland across both states. More than 7 lakh farmer families across 2,000 villages in 10 districts of Madhya Pradesh will directly benefit. In Uttar Pradesh, over 2.51 lakh hectares of additional land will come under irrigation.
The project will also supply drinking water to 44 lakh people in Madhya Pradesh and 21 lakh people in Uttar Pradesh. A 103 MW hydropower plant and a 27 MW solar energy unit will also be built as part of the package.
It does not stop there. The project also includes the restoration of 42 ancient Chandela-era heritage ponds to improve groundwater levels in the region. For Bundelkhand, where people have waited over six decades for meaningful water security, this project represents what may be their last, best hope.
Tribal Protests in Madhya Pradesh Intensify But Why?
Because the Ken-Betwa Link Project comes at a steep human and environmental price, and tribal protests in Madhya Pradesh are the clearest sign of that cost. The Daudhan Dam alone will displace 5,288 families in Chhatarpur district and 1,400 families in Panna district. These are not numbers on paper. They are generations of people whose ancestral land, farms, and forests will go underwater.
“Many families are being displaced without compensation. No one in the administration is willing to listen to us. That is why we have been protesting under this Barana bridge for nine days now,” a protester said.
The protesters say their previous agitations were suppressed through what they call “false assurances” from authorities. They now refuse to back down.
On July 8, 2026, the Madhya Pradesh government tried to contain the situation. It raised the rehabilitation compensation from Rs 5 lakh to Rs 12.5 lakh per family and added 750 more families to the rehabilitation plan. Chhatarpur Collector Parth Jaiswal told The Hindu that a fresh survey after the April 2026 protests had identified these additional families. He confirmed the state government approved an additional Rs 300 crore for rehabilitation.
The protesters rejected it. “This does not address our concerns. We will continue our agitation until all our demands are met,” community members said. Their core demand remains unchanged: land for land, not cash.
Activists from the Jai Kisan Andolan have alleged that the local administration imposed Section 163 restrictions on the protest gatherings near the project site, a move they call an attempt to silence legitimate democratic dissent.

What is Chita Andolan?
The Chita Andolan that began in April 2026, where tribal women lay on symbolic funeral pyres to protest the submergence of their land, was not the first protest. It was, however, the one that finally brought national media attention to Chhatarpur. Protests against the Ken-Betwa Link Project have been ongoing since 2023.
The National Alliance for Climate and Environmental Justice on July 16, 2026 issued a statement expressing “unflinching solidarity” with the affected communities. They condemn what it called violations of constitutional and human rights.
The Environmental Cost Nobody Is Talking About
Beyond the tribal protests in Madhya Pradesh, the Ken-Betwa Link Project faces serious environmental reckoning. The Daudhan Dam will submerge around 6,017 hectares of forest land. Over 18 lakh trees will be felled. And critically, around 10 percent of the Panna Tiger Reserve’s critical tiger habitat will go underwater permanently.
This matters because Panna’s story is one of India’s greatest conservation achievements. Tigers went locally extinct there in 2009. Conservation workers spent years carefully rebuilding the population through careful translocations and monitoring. Today there are around 35 tigers in the reserve. The Ken-Betwa project risks undoing all of that work.
An April 2025 Wildlife Institute of India report found that prey density inside the reserve had already fallen to just 6 animals per square kilometre. The ideal range is 30 to 60. Construction activity, road building, and increased human presence have already pushed herbivores northward and forced monkeys and birds to flee their traditional habitats.
The National Tiger Conservation Authority has raised concerns about forest degradation and prey scarcity in the reserve. A petition filed recently before the courts has accused the Standing Committee of the National Board for Wildlife of rubber-stamping clearances with “no application of mind.”
The Ministry of Environment did impose three conditions when it granted clearance: expand the reserve’s boundaries by 60 square kilometres, plant 2.5 million trees as compensatory afforestation, and monitor tiger and leopard behaviour through radio collaring. Whether these measures are enough is a question scientists and conservationists have answered with a firm no.
What Protesters Are Demanding?
The families protesting under the Barana bridge are asking for three things.
- First, compensation that actually reflects what they are losing, not a cash amount that cannot buy equivalent agricultural land anywhere in the region.
- Second, land for land rehabilitation, meaning they receive comparable farmland rather than money.
- Third, gender parity in compensation payouts, as women in tribal households often hold no formal land titles and are being excluded from payments.
Background on Ken-Betwa Link Project
The idea of linking India’s rivers was first seriously proposed in the 1980s. But Bundelkhand’s water crisis was identified even before that. The Ken-Betwa link project specifically has been in planning for over six decades.
Multiple governments studied it, debated it, and shelved it. The Union Cabinet finally approved funding and implementation in December 2021. PM Modi’s foundation stone laying in December 2024 formally began the construction clock.
The project is expected to be completed in eight years. For Bundelkhand farmers who have watched their children migrate to cities every summer in search of work, eight years feels like nothing compared to the six decades already lost.
The Ken-Betwa Link Project is also the proving ground for a much bigger national ambition. India’s National Perspective Plan envisages 37 river interlinking projects connecting 174 rivers across the country. Ken-Betwa is the first. If it delivers, the rest may follow.
What’s Next?
Legal petitions are being filed and court challenges are being tracked closely by environmental lawyers and tribal rights advocates. The SC-NBWL petition alone, if successful, could delay the project significantly by requiring fresh clearance processes.
For now, the tribal protests in Madhya Pradesh and the construction cranes inside Panna Tiger Reserve represent two Indias in direct collision. One India desperate for water that will irrigate its dying farms. Another India desperate to keep the land and forests that have sustained its communities for centuries.
The Ken-Betwa Link Project will not resolve that collision with money alone.
